Facility · Campus · Module · Operations

An engineered campus you can inspect.

Explore the 32-rack GB300 reference module in 3D, then see how it repeats across four 50MW halls with short, serviceable power and cooling routes.

Blue-hour aerial concept of the completed Phase One campus
Phase One at blue hour · concept
4.91MWIT capacity per reference module
32racksGB300 NVL72 at 136kW each
2,304GPUs on a 1:1 non-blocking fabric
312m²Module footprint, 24m × 13m
Reference micro-module

Thirty-two racks. One repeatable block.

Each module is its own fault domain, accepted independently and operated centrally. Drag to orbit, scroll to zoom.

GB300 NVL72 · 32-rack micro-module
Drag to orbit · Scroll to zoom
Loading 3D model…
GPU rack CDU A / B Dry cooler 800V DC busway Supply loop Return loop
24 × 13mModule footprint, 312m²
32 × 136kWGB300 NVL72 racks
2,304GPUs per module
12 × Q-X800InfiniBand, 1:1 fat tree
8 × 1.2MWCDUs, 2N redundant
12 × 120kWAir walls, N+2
1.8mHot aisle containment
800A 4N3Intelligent busway
Daylight aerial concept of the four-hall campus
Campus masterplan · concept
Phase One campus

Four halls around a shared backbone.

Halls sit east and west of a central power spine, so no hall depends on a neighbour for its cable route. Water infrastructure runs along the north edge and the reservoir lies 20m to the south.

22m halls give headroom for liquid pipework and roof plant from day one.

Halls
4 × 50MW · 3 floors · 22m
Power spine
2 genset buildings · 80 × 2,500kW
Fuel
Below-grade store, 48h full load
Substation
220kV, dual route, east side
Water
8 × 1,250m³ tanks · treatment · fire pumps
Operations
3-storey NOC/ECC and customer offices
Delivery models

From white floor to servers-in-and-running.

Choose the handover level that matches your team. The smallest customisable unit is a 2.5MW data hall.

Traditional

White floor

Customer designs M&E, procures CDUs and installs busway and network.

  • 12–18 month fit-out and commissioning
  • Maximum design control
  • Longest time to first token
Flexible

Tiered handover

White floor, M&E fitted or ready to deploy, split and combined across phases.

  • 2.5MW minimum unit
  • Mix levels across halls
  • Phase-aligned commitments
Service commitments

99.99% availability, written into the contract.

Power and environmental stability are contractual, with rent credit if targets are missed.

99.99%Monthly SLA

Power supply and hall environment, with credit terms.

15minP1 response

Cold plates, optics, pumps and switches held in a bonded campus store.

48hFuel reserve

Full-load islanded runtime from the below-grade store.

10,000m³On-site water

Eight-tank buffer against any external supply disruption.

Operations & security

Internet-grade operations, full stack.

Availability

Tier III+ concurrently maintainable

N+1 / 2N redundancy across power, cooling and network, so any single component can be serviced without downtime.

Visibility

24/7 NOC/ECC with DCIM API

Bilingual on-site team with hyperscale SOPs. Read-only API for rack power, Delta-T and flow in real time.

Security

Layered physical isolation

Two-factor biometric access, 360° CCTV retained 90+ days, dedicated staging and controlled customer routes.

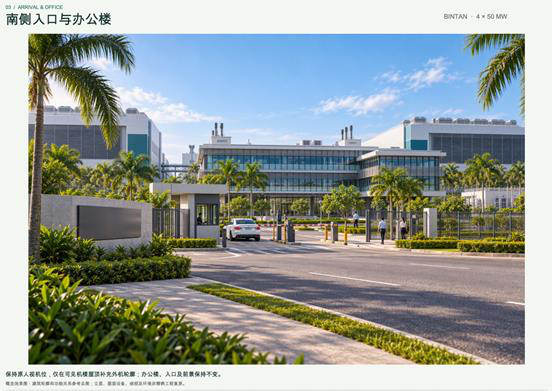

South entrance and operations building concept
South entrance · concept
Arrival

An enterprise front door.

The south entrance brings visitors past a security checkpoint into an arrival plaza and the three-storey operations building, home to the global NOC/ECC and customer offices.

Arrange a visit

Capacity planning

Reserve your first module.

Share your rack density, timeline and handover preference and we will scope the right hall allocation.

Continue the briefContact
